Generally Accepted Scheduling Principles (GASP)



The Generally Accepted Scheduling Principles (GASP) are

eight overarching tenets for building, maintaining, and using

schedules as effective management tools.



GASP is concise and easily understood, yet set high

expectations for program management teams to develop

and use schedules.

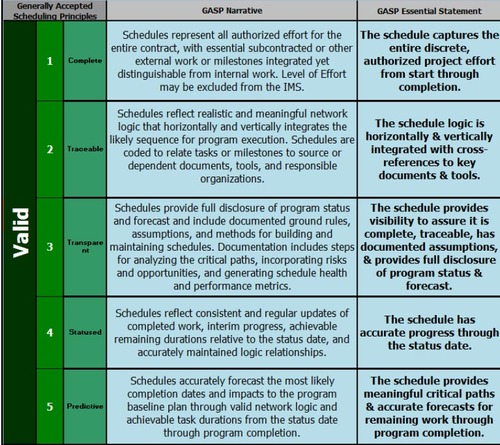

The first five GASP tenets describe the requisite qualities

of a valid schedule; that is, one that provides complete,

reasonable, and credible information based on realistic logic,

durations, and dates. The latter three GASP tenets reflect

increased scheduling maturity that yields an effective schedule.



An effective schedule provides timely and reliable data,

aligns time phased resources and  is built and maintained

using controlled and repeatable processes.



GASP serves several purposes. First, they are high

level tenets, or targets, for sound scheduling.

GASP also serves as a validation tool for the program

team or organization to assess schedule maturity or schedule

areas needing improvement. Lastly, GASP can be used

as a governance tool to assess new or different scheduling

approaches with objectivity and detachment.

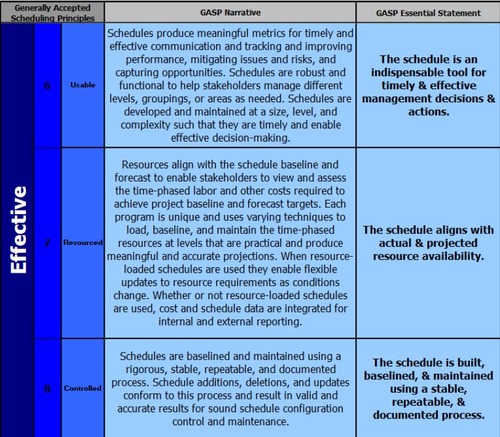

Achieving a GASP compliant schedule indicates the schedule

is not merely healthy, but fit. A healthy schedule is functional

and meets minimum management purposes, but a fit schedule

is robust and dynamic.



A fit schedule provides the program team with a program

execution roadmap of meaningful progress and realistic

forecasts against a resource loaded  performance  baseline.

Thus, meeting all eight GASP tenets demonstrates that the

program team builds and maintains the schedule with rigor

and discipline so that the IMS remains a meaningful

management tool from program start through completion.
